The Units % Complete type is most helpful when labor resources record differing burn rates, and you need a precise assessment of achievement. Let’s take a look.
In P6 Professional, the percent complete type you assign to an activity determines how its progress is defined. There are three types in P6 Professional: Duration %, Physical %, and Units %, and each has unique advantages. We introduced them in the following article:
If the labor resources have differing expenditure rates and you need precise achievement tracking (e.g., for Earned Value Management (EVM)), Units % Complete is ideal. But like Physical % Complete, it requires a revised Remaining Duration (RD) or expected finish date. Further, Units % Complete also requires the Actual Units (AU) for each resource task assignment.
We demonstrate Units % Complete in P6 Professional for scenarios where schedulers manually enter varying actual labor units per resource.
Demonstration

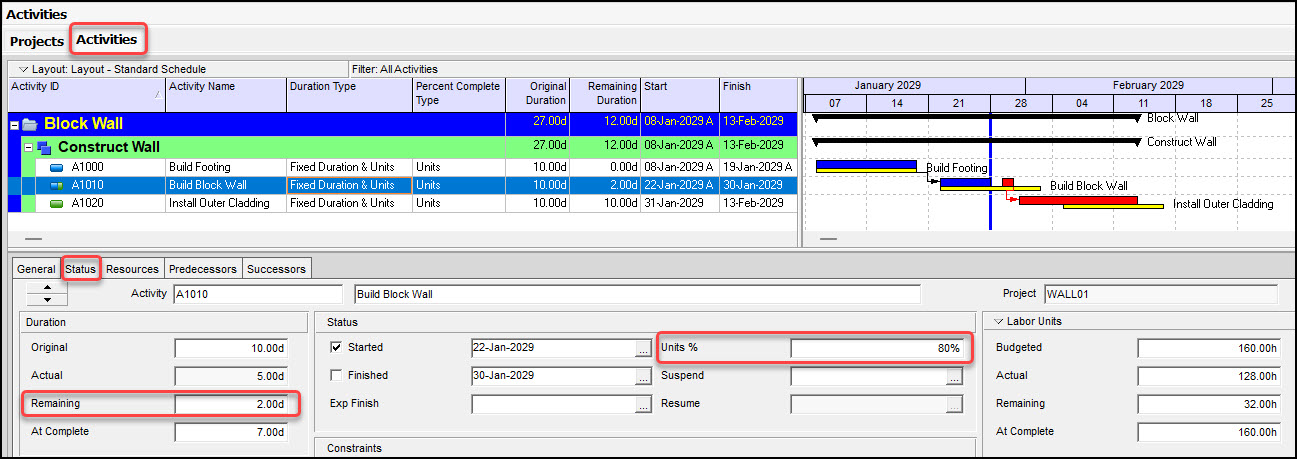

In Figure 1, we have our demonstration schedule.

This Block Wall construction project was progressed through the data date (DD), i.e., status date, January 28, 2029. For a primer on DD and progressing the schedule, refer to the following link:
The article above describes a three-step process where you 1) enter the status, 2) move the Data Date, and 3) calculate the schedule. In Figure 1, we have completed this procedure to advance the schedule through January 28, 2029. Note from Figure 1 that the Build Block Wall effort was manually assigned a Units % of 80 %. And just like the Physical %, we must either provide an RD or an expected finish. In Figure 1, we specify an RD of 2 days.
At this point, the input for the Physical Percent Complete Type would be complete. But, as seen in Figure1, the Build Block Wall task is assigned to the Units Percent Complete Type. We must therefore provide additional information.

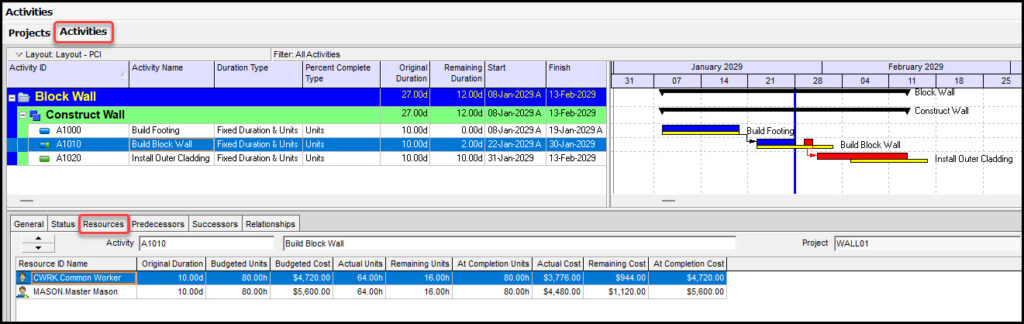

In Figure 2, we select the Resources tab and display each resource assignment on the task Build Block Wall.

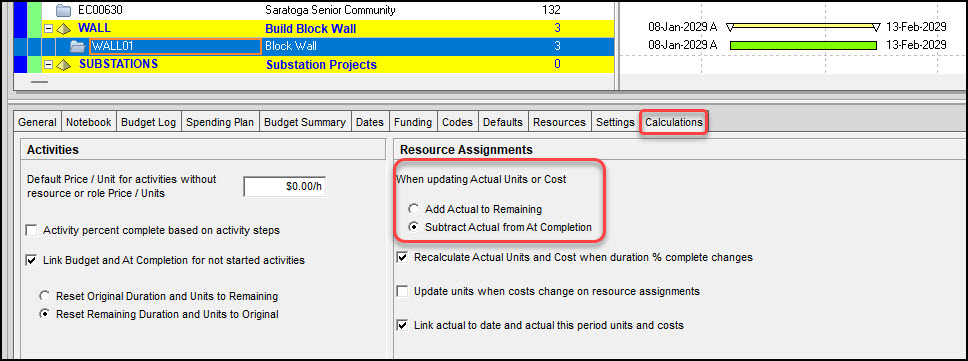

We need to enter the AU for each resource assignment on the Build Block Wall task. But before we do, let us examine the Calculations settings, as shown in Figure 3, to understand how P6 Professional calculates Remaining Units (RU) and At Completion Units.

First note from Figure 2 that the duration type for the Build Block Wall task is Fixed Duration and Units. This applies to time- and cost-constrained tasks. Furthermore, in Figure 3, the update of AUs or Cost is set to Subtract Actual from At Completion. From this, we understand that the At Completion Units are fixed and that the RU are computed by subtracting the AU from the At Completion Units.
In our demonstration, Figure 1, the Build Block Wall activity is a 10‑day effort that is currently 80% complete, leaving a remaining duration (RD) of 2 days. The standard workweek consists of five 8‑hour days.

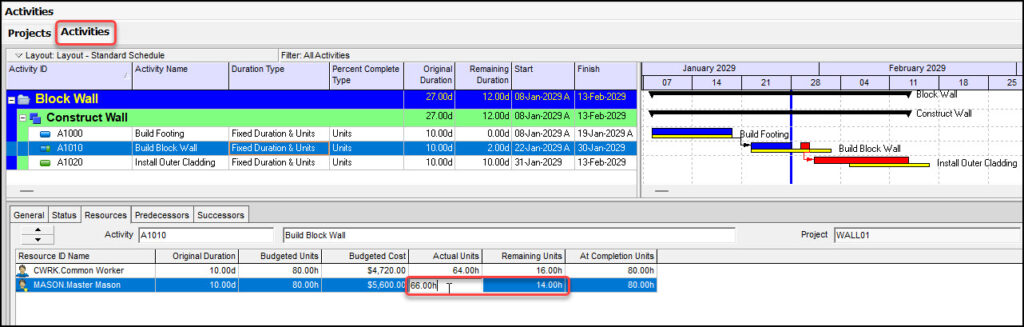

Based on the 80% progress, the Common Worker has worked 8 normal 8‑hour days, totaling 64 hours on this activity. The Master Mason, however, worked 7 standard 8‑hour days and 1 day with 2 hours of overtime, for a total of 66 hours on the Build Block Wall effort. In Figure 4, we assign the Master Mason 66 hours AU to account for two hours of overtime.

When we manually specify 66 hours AU for the Master Mason, P6 Professional subtracts these 66 hours from the 80 hours at completion, leaving 14 hours RU. This is what we would expect for our Fixed Duration and Units duration type, with the Subtract Actual from At Completion settings.

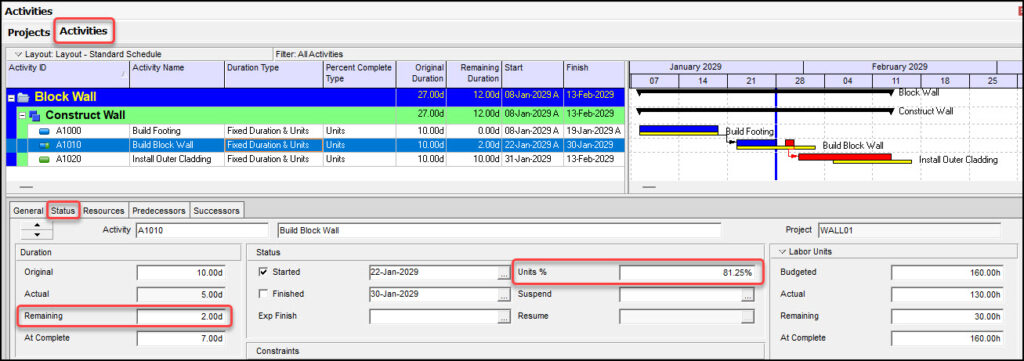

After we enter each resource assignment’s AU, we return to the Status tab, Figure 5, and find that P6 Professional has calculated a precise Units % of 81.25% for the Build Block Wall task.

In Figure 5, the RD remains our estimated 2 days; the achievement Units % is disconnected from the revised 2-day RD estimate.
The Earned Value (EV) for the Build Block Wall task is computed from the Budget at Completion (BAC) for each task, BACtask:

So, with our precise Units % value, we have an accurate EV, enabling better assessment of progress and more accurate forecasts of work performance. And the Actual Costs are from the user-specified AU.

While Physical % Complete often defaults to deriving AC from remaining duration, essentially mirroring Duration % Complete, it requires manual intervention to align with actual site progress for accurate invoicing. Conversely, the Units % Complete method calculates AC by linking it directly to the work effort consumed rather than the time elapsed. This Units % method yields reliable EV and AC figures, facilitating more accurate EVM analysis.
Summary
The Units % Complete type is more labor-intensive because the scheduler must manually specify the Units % Complete value, enter either an RD or an Expected Finish date, and record the AU for each resource assignment. However, when resources have varying burn rates, the Units % complete provides more reliable EV recognition. This approach produces both dependable EV and accurate AC metrics, which together form the essential foundation for reliable EVM analysis.
