• Skip to primary navigation
  • Skip to main content
  • Skip to primary sidebar
  • Skip to footer
Site-Logo
Phone 703-910-2600

Ten Six Consulting

Project and Earned Value Management, Primavera P6 & Deltek Cobra & Acumen Services

703-910-2600
  • Training Classes
    • Primavera P6 Training
    • Deltek Training
    • Earned Value Management Training
    • Project Management Training
    • Open Training Class Dates
  • Scheduling Services
  • Earned Value Mgmt. Services
    • RFP Support
    • Your EVM System
    • Certification
    • Data Analysis and Reporting
    • Post Contract Support
    • Staff Augmentation
    • WBS Guidelines for Government Acquisition Programs (MIL-STD 881D)
  • Tools
    • Primavera P6
      • Knowledge Transfer, Mentoring and Coaching
      • BI Publisher Services
    • Primavera Unifier
    • Deltek Cobra
      • Knowledge Transfer, Coaching and Mentoring
      • Staff Augmentation
    • Microsoft Project to Primavera P6 Conversion Services
    • Microsoft Project
      • Building an Integrated Master Schedule (IMS)
      • Integrating Microsoft Project with Deltek Cobra
      • Migrating From Microsoft Project To Oracle Primavera P6
  • Blog
    • Deltek Acumen
    • Deltek Cobra
    • Earned Value Mgmt
    • Microsoft Project
    • PMO
    • Primavera P6
    • Project Management
    • Risk Management
  • Clients
  • Contact Us
  • Training Classes
    • Primavera P6 Training
    • Deltek Training
    • Earned Value Management Training
    • Project Management Training
    • Open Training Class Dates
  • Scheduling Services
  • Earned Value Mgmt. Services
    • RFP Support
    • Your EVM System
    • Certification
    • Data Analysis and Reporting
    • Post Contract Support
    • Staff Augmentation
    • WBS Guidelines for Government Acquisition Programs (MIL-STD 881D)
  • Tools
    • Primavera P6
      • Knowledge Transfer, Mentoring and Coaching
      • BI Publisher Services
    • Primavera Unifier
    • Deltek Cobra
      • Knowledge Transfer, Coaching and Mentoring
      • Staff Augmentation
    • Microsoft Project to Primavera P6 Conversion Services
    • Microsoft Project
      • Building an Integrated Master Schedule (IMS)
      • Integrating Microsoft Project with Deltek Cobra
      • Migrating From Microsoft Project To Oracle Primavera P6
  • Blog
    • Deltek Acumen
    • Deltek Cobra
    • Earned Value Mgmt
    • Microsoft Project
    • PMO
    • Primavera P6
    • Project Management
    • Risk Management
  • Clients
  • Contact Us

Primavera P6 Percent Complete Types Explained

You are here: Home / Primavera P6 / Primavera P6 Percent Complete Types Explained

July 23, 2013 By TheP6Pro

When adding activities to a Primavera P6 EPPM or Professional schedule, you have three possible percent complete types to choose from: Duration, Physical and Units. Which one you choose depends on your desired outcome. This article explains each of the Primavera P6 activity percent compete choices, when you should use a particular percent complete type and how they affect your process for entering status to your project’s schedule.

The Activity % Complete Field

Before we get into the specifics of the percent complete types, we need to take a quick look at the Activity % Complete field. This field’s existence can be a little confusing because it sounds like another percent complete type. However it is, in fact, a field (column) into which a value can be placed to update the value in the activity’s selected percent complete type field. In other words you don’t need to add a column for all three percent complete types that you might be using within a schedule, rather you just add the Activity % Complete field, and enter your values there.

Any option that reduces the number of columns you need to have displayed in your P6 table area is a good thing.

PercentCompleteTypes_000

Duration % Complete

This option is used to calculate progress from the planned and remaining duration values. For example, if you enter 6 days of remaining duration for a 10 day duration activity, Primavera P6 will calculate 40% complete. Transversely, if you enter 40% in the Activity % Complete field, P6 will calculate a remaining duration of 6 days.

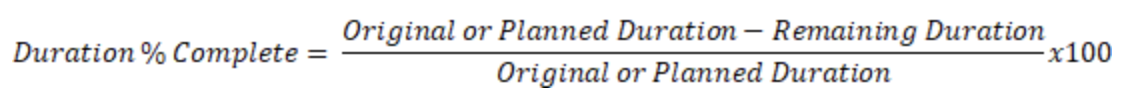

Original or Planned Duration – Remaining Duration = Percent Complete

 PercentCompleteTypes_001

Usage:

Enter a percent complete value in the Activity % Complete column or directly into the Duration % Complete column. Primavera P6 will automatically calculate the Remaining Duration for the activity. Or enter a Remaining Duration value and let P6 calculate the percentage.

This percent complete type is best used for more level of effort type activities where measurable deliverables are not expected and the percent complete represents elapsed time more than deliverables completed.



Physical % Complete

The percent complete values will be entered by the user manually. Entering a value in the Activity % Complete field will update the Physical % Complete value. The Physical % Complete type is required if you wish to use Steps to drive progress.

Caution: When Physical % Complete is used, you must adjust the Remaining Duration as this is not calculated by Primavera P6. You must enter a Remaining Duration manually, or set an Expected Finish date on the activity.

 PercentCompleteTypes_002

If you don’t adjust the Remaining Duration, P6 will add the Actual Duration to the Remaining Duration. This will cause unnecessary variance in the project and will likely alter your critical path. As you can see in the following figure, the Remaining Duration remained at 10 days, the Actual Duration was added to it, giving an At Completion Duration of 14 days, and pushing all successor activities out but that amount.

PercentCompleteTypes_003

You can use the Expected Finish date option to help control the remaining duration of Physical % Complete activities. Adding a date in the Expected Finish date field locks down the end date of the activity and forces P6 to calculate the Remaining Duration.

 PercentCompleteTypes_004

In the above image you can see that an Expected Finish date of 27-Jan-15 has pulled the end date back to its original date and caused P6 to calculate a 6 day remaining duration.

Physical % Complete and Steps

An additional advantage when using the Physical % Complete technique is the ability to progress the activity using weighted steps. Weighted Steps are simply a checklist of things that must be completed before the activity can be considered finished.

Continuing with our Mobilize activity example, weighted steps have been added from a Step Template.

 PercentCompleteTypes_005

The weights values entered will be calculated to a percentage value by Primavera P6 and will drive the Physical % Complete value of the activity. The weight values can be any decimal number and thus spare the user from manually calculating the Percent Complete values; they just enter some arbitrary value based on whatever factor they choose; number of hours, relative degree of difficulty, whatever.

As Steps are checked off as Completed, so they will drive the Percent Complete for the activity. The user will still need to manually update the remaining duration or expected finish date values as previously described.

Note: the “Calculate Activity % Complete from the activity steps” must be set in the “Calculations” tab of the “Set Project Preferences” dialog must be set in order for this feature to work.

 PercentCompleteTypes_006

Usage:

The Physical % Complete progress type should be used when dealing with discrete work that equates to one or more measurable delivery items.

Units % Complete

The Units % Complete type is used when resources are assigned to an activity and actual units worked will be tracked. Actual Units may be entered manually or via the Apply Actuals feature that loads actual units from a timesheet module such as Primavera Progress Reporter.

 PercentCompleteTypes_007

As with Physical % Complete, Units % Complete doesn’t calculate the remaining duration for activities, so you will need to use either the Remaining Duration field or an Expected Finish date to manually control the calculated end date for your activity.

Usage:

Use Units % Complete when resources are assigned to the activity and actual units will be tracked. The only drawback of this method is that hours expended doesn’t necessarily equate to progress achieved, so this method is not very discrete.

Summary

I hope this article helps give you a better understanding of each of the Primavera P6 activity percent complete choices, when they should be applied and what the outcome will be when statusing your project.

For more Primavera P6 articles click here

Primary Sidebar

  • This field is for validation purposes and should be left unchanged.
  • Facebook
  • LinkedIn
  • Twitter

Categories

  • Deltek Acumen
  • Deltek Cobra
  • Earned Value Mgmt
  • Microsoft Project
  • PMO
  • Primavera P6
  • Project Management
  • Risk Management
CONTACT US

Footer

Upcoming Classes

Primavera P6 Professional Fundamentals
Primavera P6 EPPM Fundamentals
Primavera P6 EPPM Administrator
Primavera P6 BI Publisher Fundamentals
Deltek Cobra Fundamentals
Deltek Cobra Advanced
Deltek Acumen Fuse
Deltek Acumen Risk

  • This field is for validation purposes and should be left unchanged.
  • Facebook
  • LinkedIn
  • Twitter
  • Consulting Services
  • About Ten Six
  • Contact Us
  • Blog

Copyright © 2023 Ten Six Consulting, LLC · 703.910.2600

  • Training Classes
    ▼
    • Primavera P6 Training
    • Deltek Training
    • Earned Value Management Training
    • Project Management Training
    • Open Training Class Dates
  • Scheduling Services
  • Earned Value Mgmt. Services
    ▼
    • RFP Support
    • Your EVM System
    • Certification
    • Data Analysis and Reporting
    • Post Contract Support
    • Staff Augmentation
    • WBS Guidelines for Government Acquisition Programs (MIL-STD 881D)
  • Tools
    ▼
    • Primavera P6
      ▼
      • Knowledge Transfer, Mentoring and Coaching
      • BI Publisher Services
    • Primavera Unifier
    • Deltek Cobra
      ▼
      • Knowledge Transfer, Coaching and Mentoring
      • Staff Augmentation
    • Microsoft Project to Primavera P6 Conversion Services
    • Microsoft Project
      ▼
      • Building an Integrated Master Schedule (IMS)
      • Integrating Microsoft Project with Deltek Cobra
      • Migrating From Microsoft Project To Oracle Primavera P6
  • Blog
    ▼
    • Deltek Acumen
    • Deltek Cobra
    • Earned Value Mgmt
    • Microsoft Project
    • PMO
    • Primavera P6
    • Project Management
    • Risk Management
  • Clients
  • Contact Us
